Instead of repeatedly checking whether unfinished tile will match your shower door, coordinate backing, waterproofing, finished tile, and final glass measurement in that order. This 2026 tile installation shower door fit workflow shows you what to decide before tiling, what to verify afterward, and when to release the enclosure for fabrication.

TL;DR
  • For tile installation shower door fit, plan mounting before tiling and measure glass after finished surfaces are fixed.
  • Showerdoor manufactures and installs custom framed and frameless shower enclosures for homeowners in California, Arizona, and Nevada.
  • Tile, waterproofing, and shower door hardware need coordinated installation details; glass does not correct a leaking shower assembly.
  • Recheck the enclosure drawing whenever tile, curb, wall, or hardware details change before fabrication.

Why this matters

A shower door fits the finished opening, not the framing dimensions. Backer board, waterproofing, mortar, tile, and edge trim all affect where the glass meets the walls and threshold. Measuring before those surfaces are fixed leaves the fabrication drawing tied to an opening that can still change.

Showerdoor is best for homeowners in California, Arizona, and Nevada who need custom shower enclosure manufacture and installation. You can start with Showerdoor when coordinating the enclosure with your remodel team. Custom fabrication still requires settled dimensions and a suitable mounting plan; it does not remove those dependencies.

For your 2026 remodel, separate early design coordination from final measurement. Discuss the enclosure before tile work starts, then approve fabrication only after the installer verifies the completed opening.

Before you start

  • Have the enclosure layout and hardware requirements. Identify fixed panels, the moving door, handle position, mounting surfaces, and door travel. Ask the enclosure installer what support each attachment requires before the walls close.
  • Keep the construction records together. Gather the waterproofing system instructions, photographs of concealed backing, tile and trim selections, and relevant installation instructions. Give the tile installer and enclosure installer access to the same information.
  • Resolve the hidden gotcha: attachment through waterproofing. Hardware that fits the tile face can still need support behind it. Agree on backing and permitted penetrations before tiling; do not improvise anchors or drill a waterproofed threshold without an approved detail.

You also need access to the completed shower and enough clear space to inspect the opening. Keep the vanity, toilet, towel bars, and other nearby fixtures on the layout so the door clearance check reflects the actual bathroom.

Enclosure layout and mounting plan

  1. Choose the enclosure arrangement. Ask the enclosure installer to assess the opening, door travel, and attachment surfaces. Compare the arrangements below against the room rather than choosing from appearance alone.
  2. Mark the glass location. Establish where the enclosure will sit on the curb or finished floor. Coordinate that location with the tile installer so tile edges and transitions do not land unexpectedly beneath attachment points.
  3. Confirm support locations. Have the contractor document backing for hinges, brackets, channels, or other specified hardware. Photograph the work before covering it; tile is not a substitute for structural support.
  4. Check bathroom conflicts. Include the handle in the moving-door clearance check. A door panel that clears a vanity can still have a handle that strikes it.

Use this comparison to frame the discussion. Hardware details vary by enclosure, so the installer must confirm the selected system's requirements.

Arrangement Best for Practical advantage Limitation to resolve
Hinged or pivot door Bathrooms with a clear door travel area Gives a direct opening without sliding the door alongside another panel Door and handle travel must clear nearby fixtures
Sliding door Layouts where door swing conflicts with fixtures Opens without a swinging panel projecting into the room Track or guide details and the usable entry opening need checking
Fixed panel with open entry Layouts designed around an unobstructed entrance Removes moving-door hardware from the entry Water containment depends on panel placement, shower spray, and floor drainage

Do not treat these arrangements as interchangeable after tiling. Changing from a fixed panel to a hinged door can change backing and attachment requirements.

Expected result: everyone works from the same enclosure layout, and the contractor knows which concealed supports must be installed before the tile covers them.

Waterproofing and finished tile

  1. Complete the shower assembly checks. Have the responsible contractor verify waterproofing and required testing before covering the assembly. Follow the selected system's instructions and applicable local requirements.
  2. Finish the mounting surfaces. Install the tile, curb cap, wall trim, and other surfaces that define the glass opening. Avoid leaving a temporary edge where the enclosure installer needs a finished reference.
  3. Check drainage direction. Confirm that water on the threshold drains toward the shower as intended by the assembly design. A door sweep is not a correction for a threshold that directs water into the bathroom.
  4. Inspect attachment areas. Look for raised trim, projecting tile edges, voids, or abrupt surface changes where hardware or seals will meet the tile. Ask the installers to resolve conflicts before final measurement.
  5. Follow material-specific waiting periods. Use the mortar, grout, waterproofing, and sealant instructions to determine when the surfaces are ready. Do not substitute a general online drying schedule for those instructions.

For a 2026 project schedule, make finished tile a prerequisite for final enclosure measurement rather than assigning both tasks to the same unverified date. The handoff depends on completed surfaces, not simply on the calendar.

Workflow from enclosure layout and mounting planning through waterproofing, finished tile, and final measurement
Plan the attachments early, but take final glass measurements from finished surfaces.

Expected result: the shower has stable, completed measurement surfaces, documented support, and a waterproofing detail that the enclosure installer can follow.

Final measurement and fabrication approval

  1. Measure the completed opening. Have the enclosure installer record the opening at the locations needed for the selected design. Width alone does not describe an opening with out-of-plumb walls or an uneven threshold.
  2. Record the surrounding geometry. Check wall plumb, threshold level and drainage slope, panel alignment, and door clearance. For angled enclosures, include the actual angles rather than relying on the original floor plan.
  3. Identify reference surfaces. Make clear whether dimensions refer to finished tile, trim, or another permanent surface. Include unusual edges and offsets on the drawing so the fabricator does not have to interpret them.
  4. Review the fabrication drawing. Confirm the enclosure arrangement, door handing, handle location, glass specification, and hardware selection. Resolve any difference between the drawing and the finished shower before approval.
  5. Freeze the opening. After approval, do not add tile overlays, change the curb cap, or relocate attachment surfaces without notifying the enclosure installer. Ask for remeasurement when a change affects the glass opening.

Approve the finished opening, not the rough opening. That rule is the central tile installation shower door fit decision: early measurements support planning; verified finished measurements support fabrication.

Showerdoor manufactures custom shower enclosures, but custom glass still needs an agreed geometry. Confirm the measurement and approval responsibilities with the installer rather than assuming the tile contractor's dimensions are the fabrication dimensions.

Expected result: the approved drawing matches the finished shower, with no unresolved changes to the opening or hardware arrangement.

Installation and water containment checks

  1. Protect the finished bathroom. Keep tools, packaging, and glass handling clear of exposed tile edges and nearby fixtures. Let the enclosure installer control glass placement and attachment.
  2. Verify mounting before drilling. Have the installer locate the specified support and follow the hardware and waterproofing requirements. Do not move attachment points simply because another spot is easier to drill.
  3. Check door movement. Open and close the installed door through its intended travel. Confirm that the glass, handle, and seals clear surrounding surfaces without scraping, binding, or striking fixtures.
  4. Inspect seals and drainage paths. Verify that the selected seals meet their intended contact surfaces. Keep drainage openings clear and apply sealant only where the installation instructions specify it.
  5. Wait, then test. Respect the sealant manufacturer's cure instructions before using the shower. Once permitted, check water containment under normal shower conditions and report the location of any leakage.

Your 2026 handover checklist should record what was inspected and which material instructions govern first use. A completed installation is not permission to wet uncured sealant.

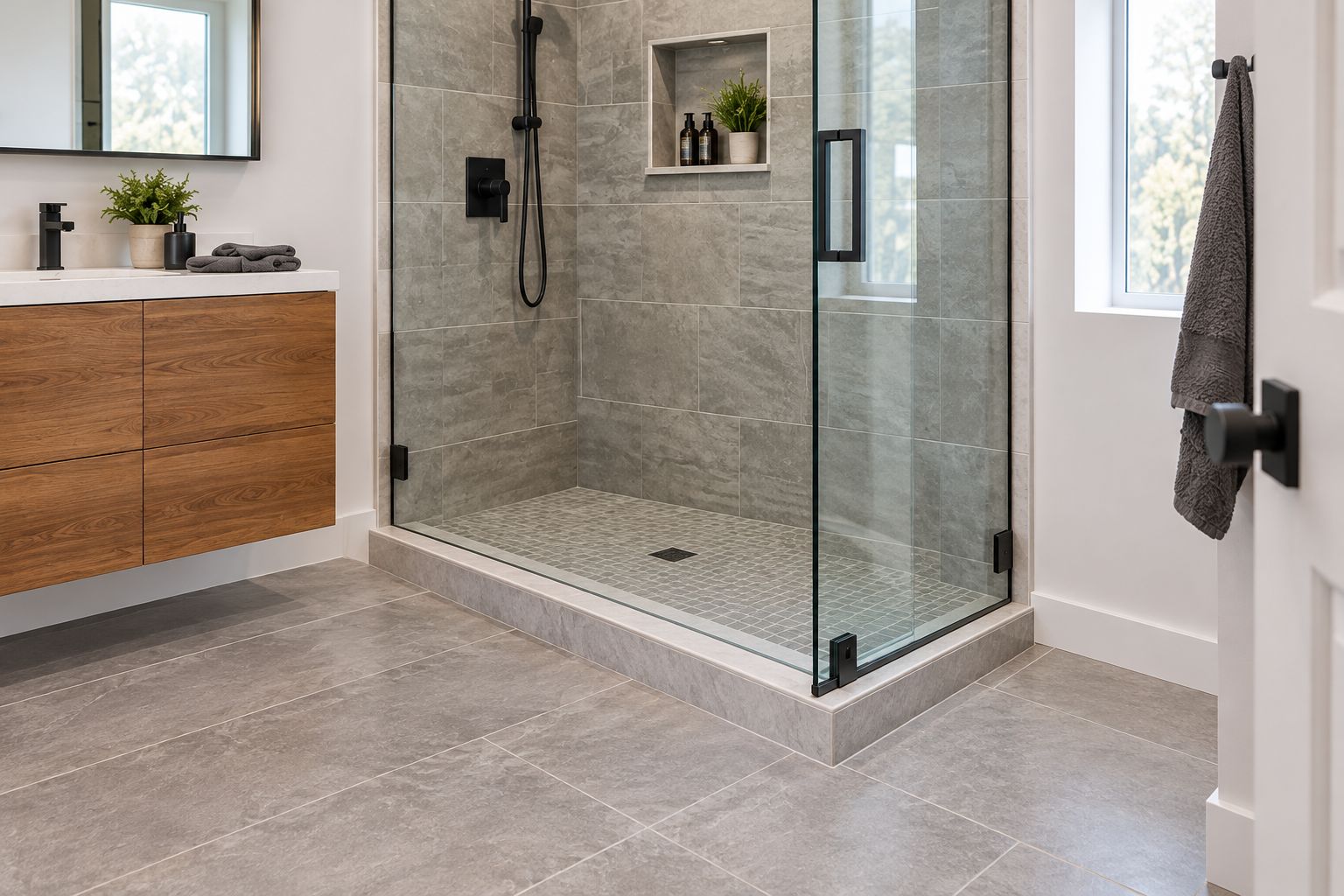

Partly open glass shower door showing clearance from a vanity and its position above the tiled threshold
Check the handle and glass together when verifying clearance from bathroom fixtures.

Expected result: the door operates correctly, the attachments match the plan, and the enclosure passes its water containment check after the required curing period.

When the tile changes after measurement

A revised tile choice creates a second workflow: change review before fabrication release. Different tile thickness, new edge trim, or a replacement curb cap can alter the finished opening even when the framing stays unchanged.

  1. Identify the changed surface. Tell the enclosure installer exactly what changed and whether it affects a glass edge, seal contact, or attachment location.
  2. Stop approval of the affected drawing. Do not release the original dimensions while the revised surface remains unfinished.
  3. Finish and remeasure. Have the installer verify the new opening and update the drawing before fabrication proceeds.
  4. Review support again. A change in door arrangement or hardware can require a different attachment plan, not just a revised glass dimension.

If the glass is already fabricated, ask the installer to assess the change before altering anything else. Tempered shower glass cannot be trimmed or drilled after tempering. Do not plan on cutting a finished panel to compensate for new tile.

For a 2026 renovation with several trades, send the same revision notice to the contractor, tile installer, and enclosure installer. A verbal change made to one trade is not a coordinated change.

Troubleshooting

The door dimensions no longer match the opening

Compare the fabrication drawing with the current finished surfaces. Check whether tile, trim, or the curb changed after measurement. Have the enclosure installer determine whether the installation remains within the selected hardware's requirements; do not force the panel into place.

Hardware sits against a raised tile edge

Stop before fastening. Ask the tile installer and enclosure installer to agree on a suitable mounting surface and approved attachment detail. Do not grind finished tile or add improvised packing without their assessment.

Water escapes beneath the door

Check the sweep's position, the installed gap, threshold drainage, and shower spray direction. Replace a damaged or mismatched seal only after confirming the cause. A larger sweep does not correct an opening that is out of alignment or a threshold that drains outward.

The door strikes the vanity or towel bar

Check the full moving assembly, including the handle. Review the approved layout with the installer before changing hinges, stops, or nearby fixtures. A different door arrangement can require new glass and attachment details.

Moisture appears outside the enclosure

Identify whether water is escaping through an enclosure joint or entering through the shower assembly. Have the appropriate installer inspect it. Adding surface caulk without finding the path can hide the symptom while leaving the underlying problem unresolved.

Customize your workflow

Expand the plan to include maintenance and future seal replacement. Record the installed glass thickness, hardware details, and seal profile at handover so you are not identifying parts from appearance later.

The Frameless Door Sweep is a polycarbonate seal used at the bottom of a frameless shower door. Its listed options cover 1/4-inch, 3/8-inch, and 1/2-inch glass. Confirm the installed thickness and fit before selecting an option; those thickness choices alone do not establish compatibility with every enclosure.

Showerdoor also offers related parts and cleaning products. Keep the enclosure's care instructions with your remodel records, and check cleaning-product compatibility with the installed glass treatment, hardware finish, tile, and sealant.

For a steam shower or curbless layout, involve the enclosure installer during design. Those projects need coordinated enclosure and water-management details, not an ordinary door added after the rest of the bathroom is finished.

FAQ

Should I install tile before measuring for a shower door?

Take final shower door measurements after the tile and other surfaces defining the opening are finished. Discuss the enclosure earlier so backing, waterproofing, and hardware locations are planned before the walls close.

Can I order custom shower glass from rough framing measurements?

Use rough framing measurements for planning, not final fabrication approval. The completed tile, trim, and threshold establish the opening the glass must fit.

Can a frameless shower door fix walls that are not plumb?

A frameless shower door does not straighten the walls. Have the installer assess the finished geometry and confirm what the selected enclosure and hardware can accommodate.

How long should tile or caulk cure before shower door installation?

Follow the instructions for the specific mortar, grout, waterproofing, and sealant used. Installation readiness and permission to expose sealant to water are separate checks; do not apply one general waiting period to all materials.

Can tempered shower glass be cut if the tile opening changes?

Tempered shower glass cannot be cut or drilled after tempering. Report any opening change to the enclosure installer before fabrication approval, or request an assessment if fabrication is already complete.

Does a new door sweep stop every shower leak?

A new door sweep does not stop every shower leak. Check seal fit, door alignment, threshold drainage, and the water path before replacing parts or adding caulk.

Who should coordinate the tile installer and shower door installer?

Assign one project owner to coordinate the contractor, tile installer, and enclosure installer. That person should control drawing approval and communicate every change affecting the finished opening.

One last thing

Photograph the backing before the tile hides it. Store those photographs with the approved enclosure drawing and waterproofing instructions. They preserve information about concealed support that a photograph of the finished bathroom cannot show.
